Weekly Updates

Week of September 21, 2026

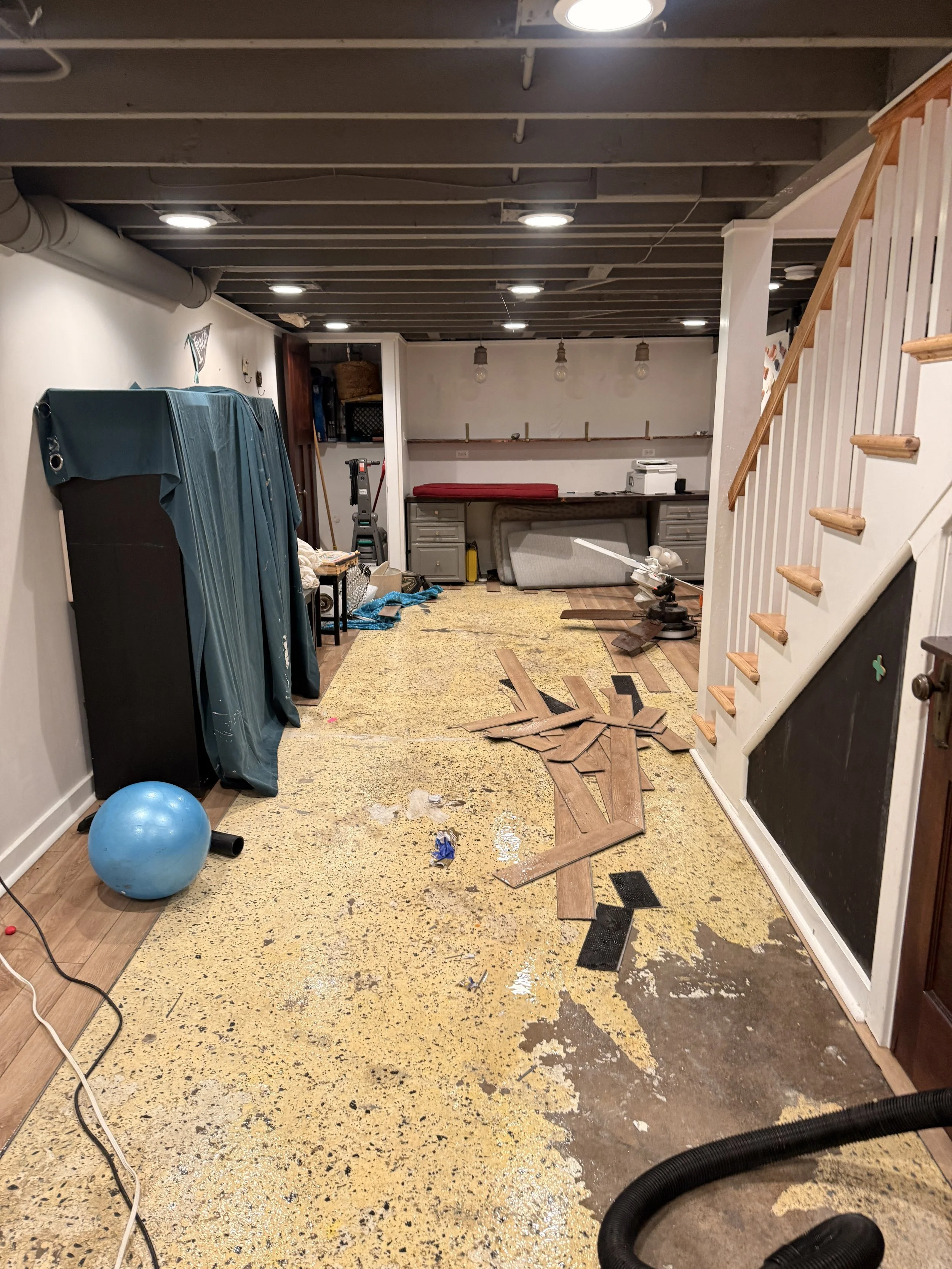

  • Installation of new flooring in the basement was completed

  • Top floor rough work was completed

  • Bathroom floor tile was installed

Week of September 14, 2026

  • Work on plumbing, HVAC, and electrical continued

  • Basement drywall was sanded and primed

Week of September 7, 2026

Week of September 3, 2026

  • Interior electrical, plumbing, and HVAC work was happening the entire week.

  • Manuel & Aaron confirmed site finishes to prepare for plumbing locations (see sheet)

Week of August 31, 2026

  • RH met with Matt & Anna on site Monday to look over the needed repairs and establish the exact needs from AKats.

    • Matt confirmed that AKats would be able to help move furniture, items to the garage, begin basement exploration, and assist in disposal of damaged items.

    • RH relayed the coming Change Orders/Extras for the rear porch and exterior masonry

    • Matt & Anna confirmed that the west shower area would not be finished, the pipes should be capped inside the wall and the floor would be tiled.

    • The east shower area is a shower pan.

    • Both sides will have a toilet

  • RH & AKats met on site to confirm this plan, establish a plan for exploratory demo in the basement to remove all moisture, and move forward.

  • AKats was on site Wednesday on to continue demo and assist Matt.

  • AKats demoed the front room, including wall plaster and reframed the walls, removing the existing 2×4 ceiling joists that were no longer in use. Matt approved the added height and decreased width. The existing walls did not have insulation. New framing allows for Matt & Anna to select insulation if desired. GC is working on cost for insulation that was outside of original scope.

  • The roof of the top floor was installed

Week of August 24, 2026

  • Aaron & Jeff met with Matt & Anna on site to review the conditions. M&A showed the additional items that were damaged and areas that needed replacement and repair.

    • The exterior front, particularly the Maple Tree, were damaged to a more significant degree than anticipated or hoped.

    • Basement rear closet has additional damage

    • Basement front closet had significant moisture, shows inside were damaged

    • Clothing needed washed

    • First floor front closet had more moisture than expected

    • There is a significant concern about mold.

  • It was confirmed that M&A will put together an inventory of items damaged and in need of replacement to determine how to proceed, considering insurance as an option.

  • AKats would be on site to assist with cleaning, item removal, and moving items to the basement to prep for additional needed work

  • It was established that once the full envelope was sealed, additional dehumidifiers would be placed on site and mold tests completed.

Week of August 17, 2026

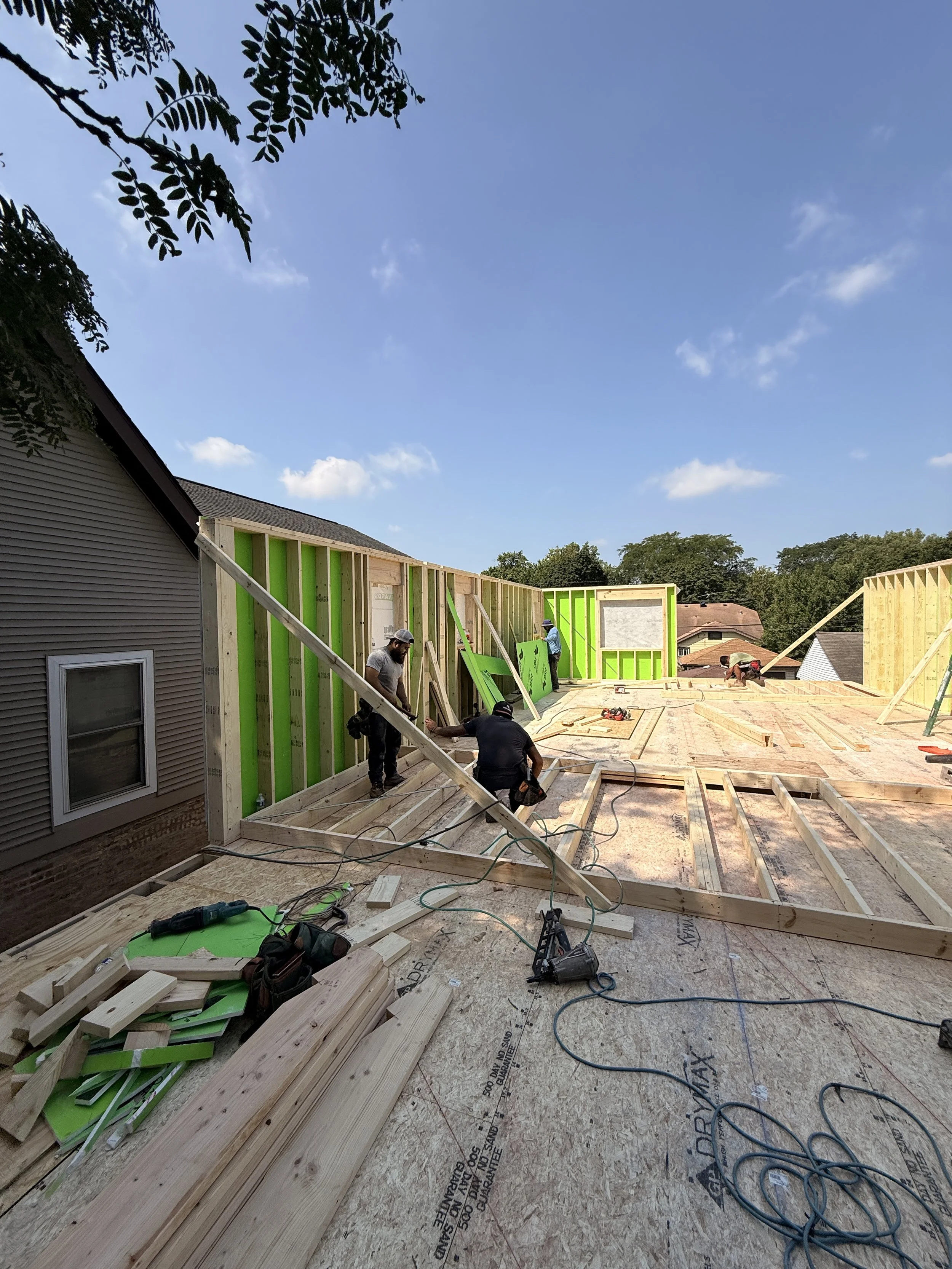

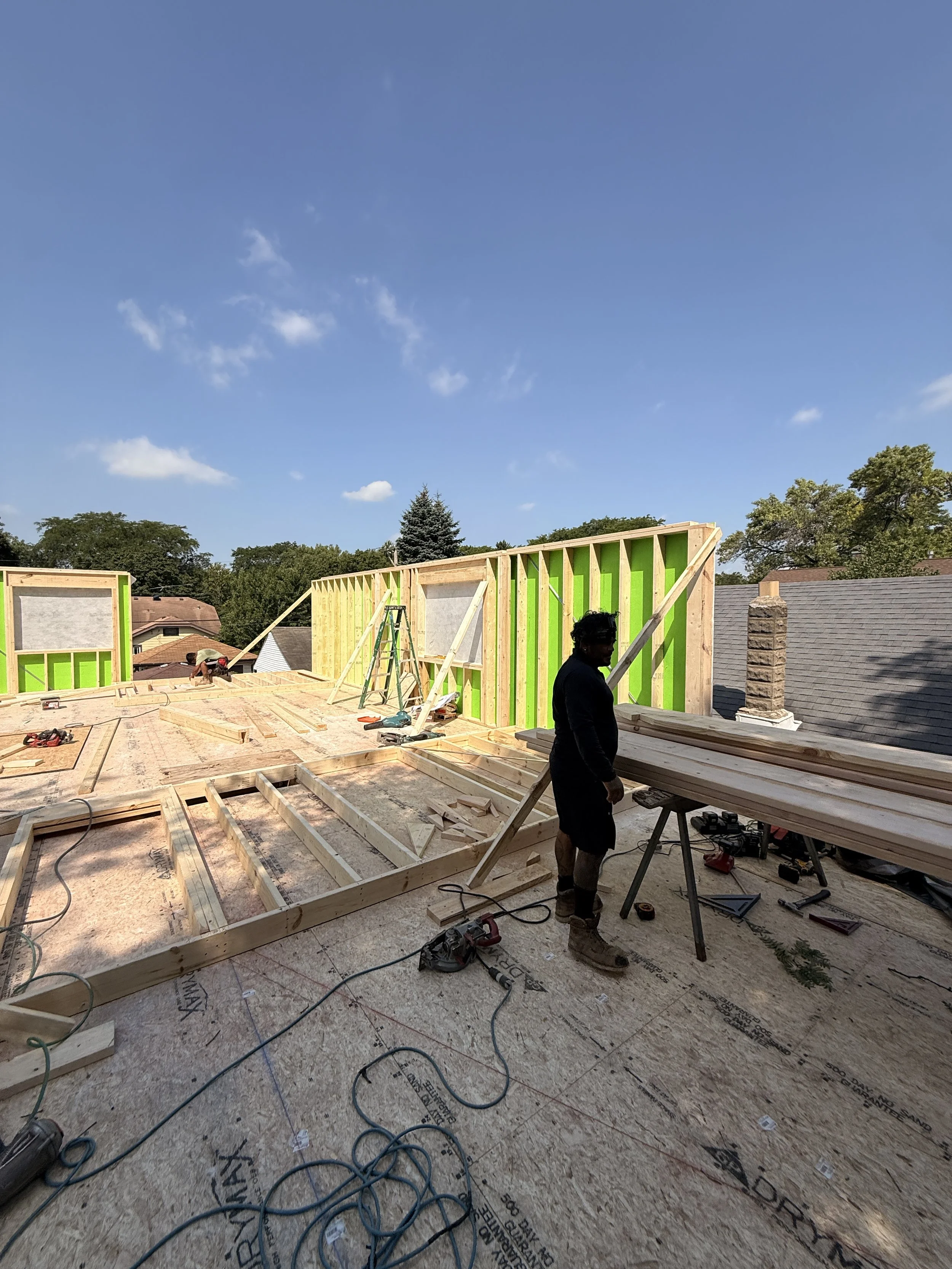

  • Framing of the top floor was completed including interior walls.

  • Manuel confirmed that the retractable ladder would be reused in the hallway at the top of the stairs.

  • The electrician started running pipes

  • Aaron, Jeff, & Manuel confirmed finishes & the level of finish for all areas of the bathroom.

    • The west side will solely have a toilet, the floor will be tiled, and walls finished with drywall. The plumbing will be capped behind the wall and beneath the floor for future installation.

    • The east side will have a toilet, a shower pan, and shower fixtures.

    • The vanity spacing and plumbing fixtures were confirmed (see finish sheet)

Week of August 10, 2026

  • The team met on site to establish needed additional work and the damages caused by storms and next steps.

  • It was identified that basement flooring will need to be replaced, ideally matching the existing to piece in all the areas where it was removed.

  • Manuel explained that the top floor joists will need to be updated to 2×10s, with the stairs needing adjusted slightly as a result. The increase from 2×8s to 2×10s may require an increase in material cost as a change order.

  • The masonry required was not outlined in the scope, AKats will review and communicate a cost for repair.

  • The cost for reframing the back porch and outlining what was in the original scope and what was additional due to the existing conditions was discussed, AKats will assemble a cost for labor and materials for the costs not included in the original scope.

Week of August 3, 2026

Construction:

  • Following the storms of the previous week, the team continued with cleanup, the additional demo, and began framing the top floor.

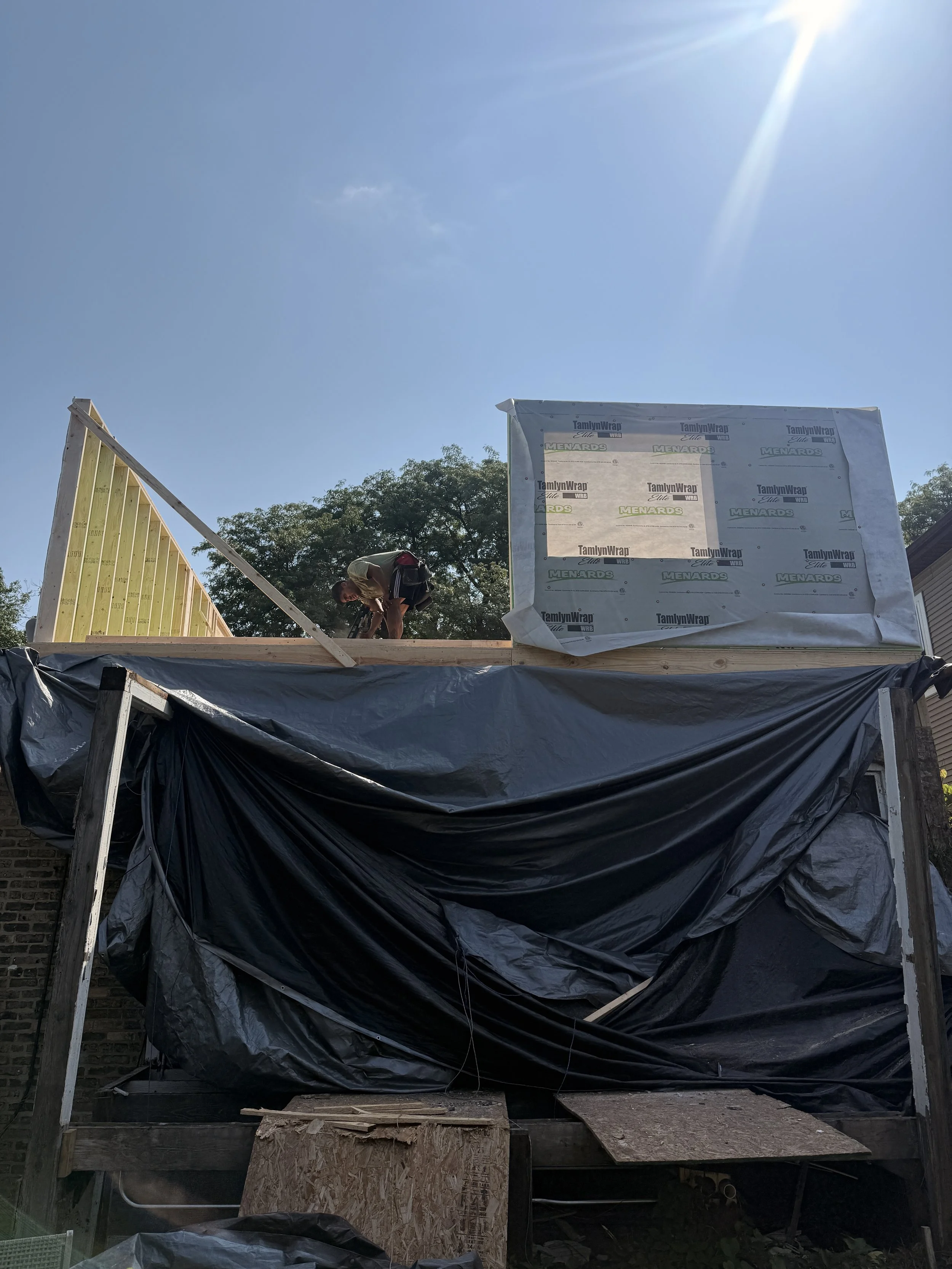

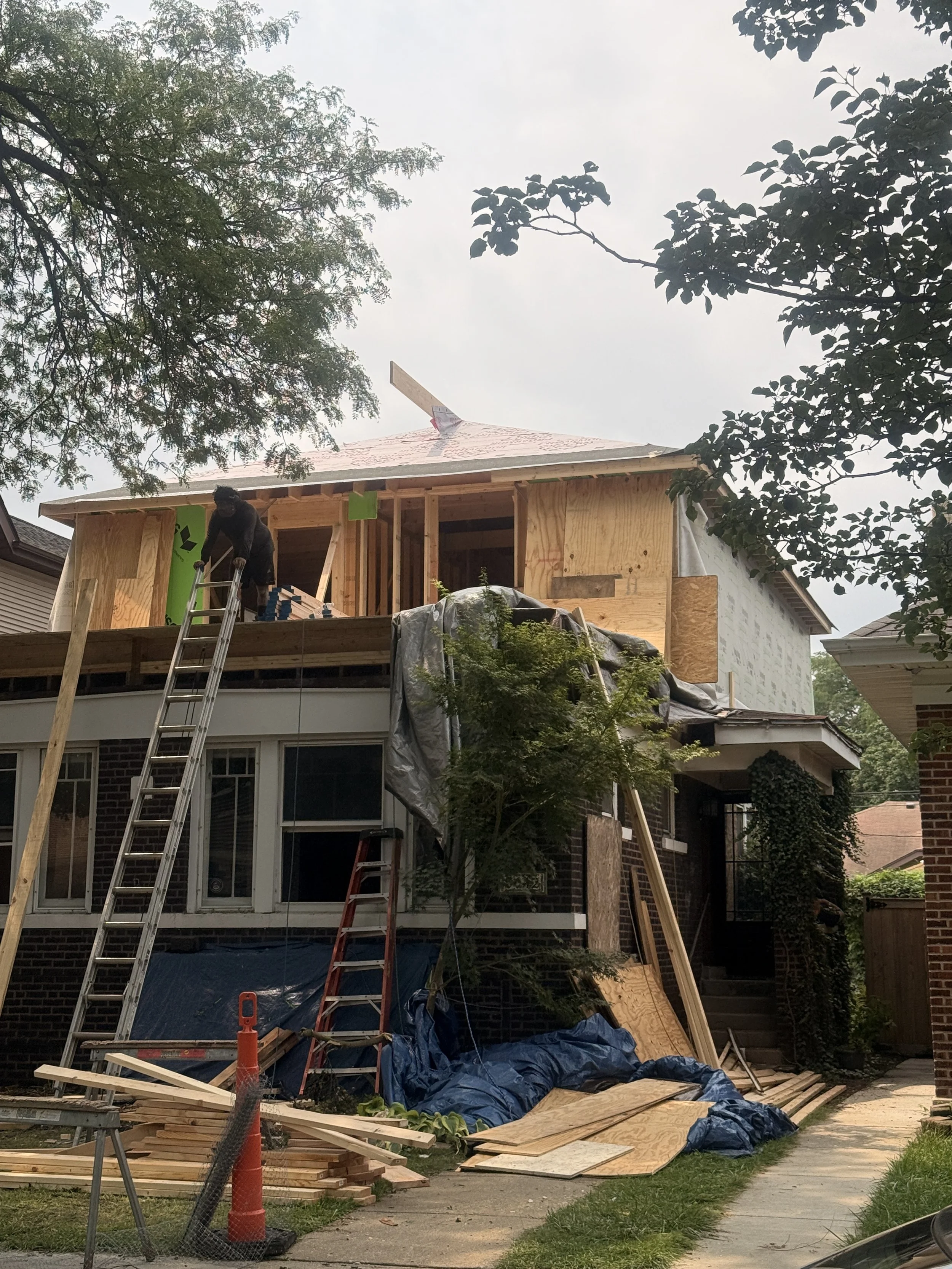

  • The week ended with the top floor framing wrapping up and the roof going on.

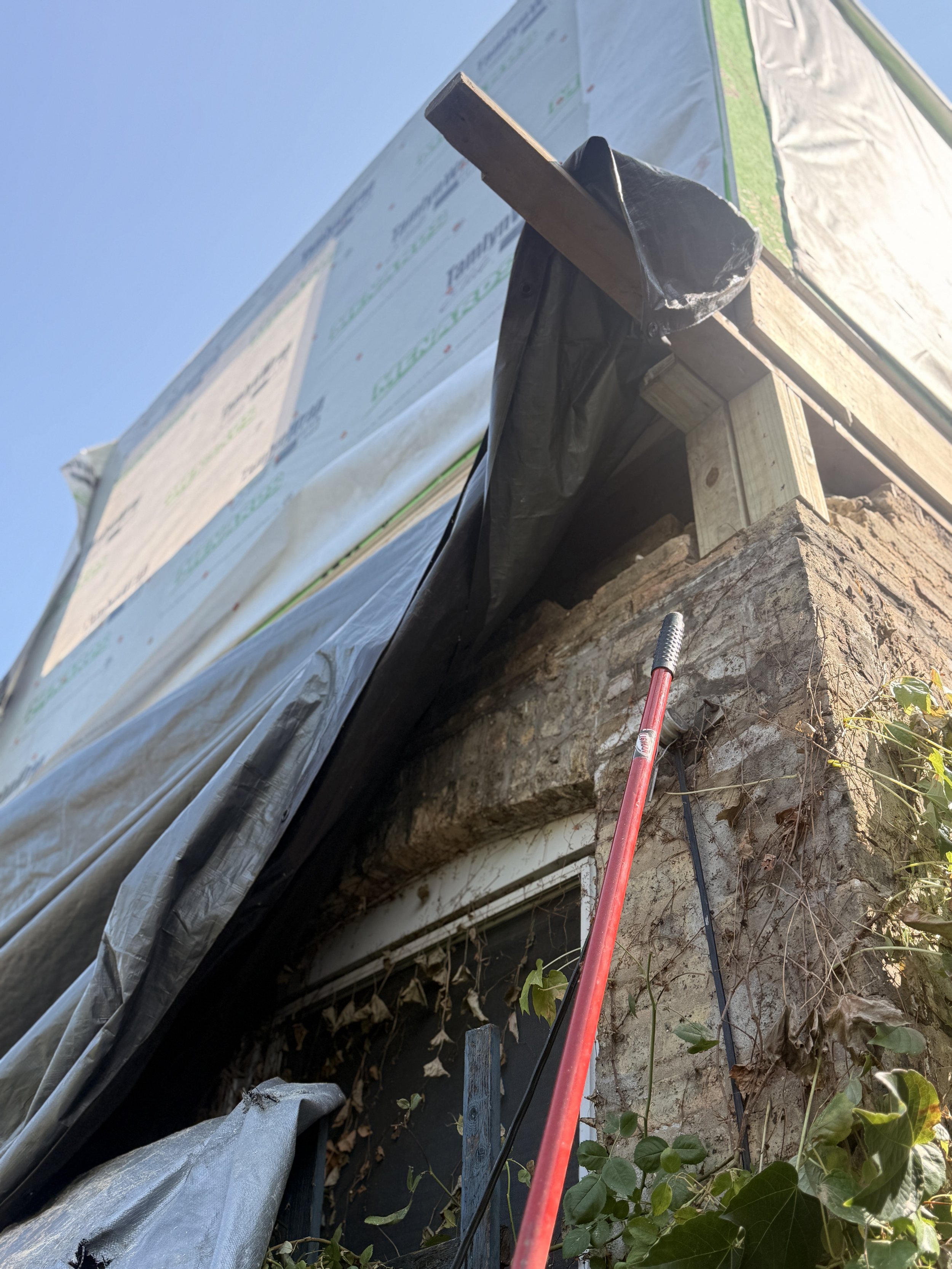

  • Framing the top floor revealed needed masonry work around the top of the first floor exterior and adjustments to framing to ensure a level second floor.

Week of July 27, 2026

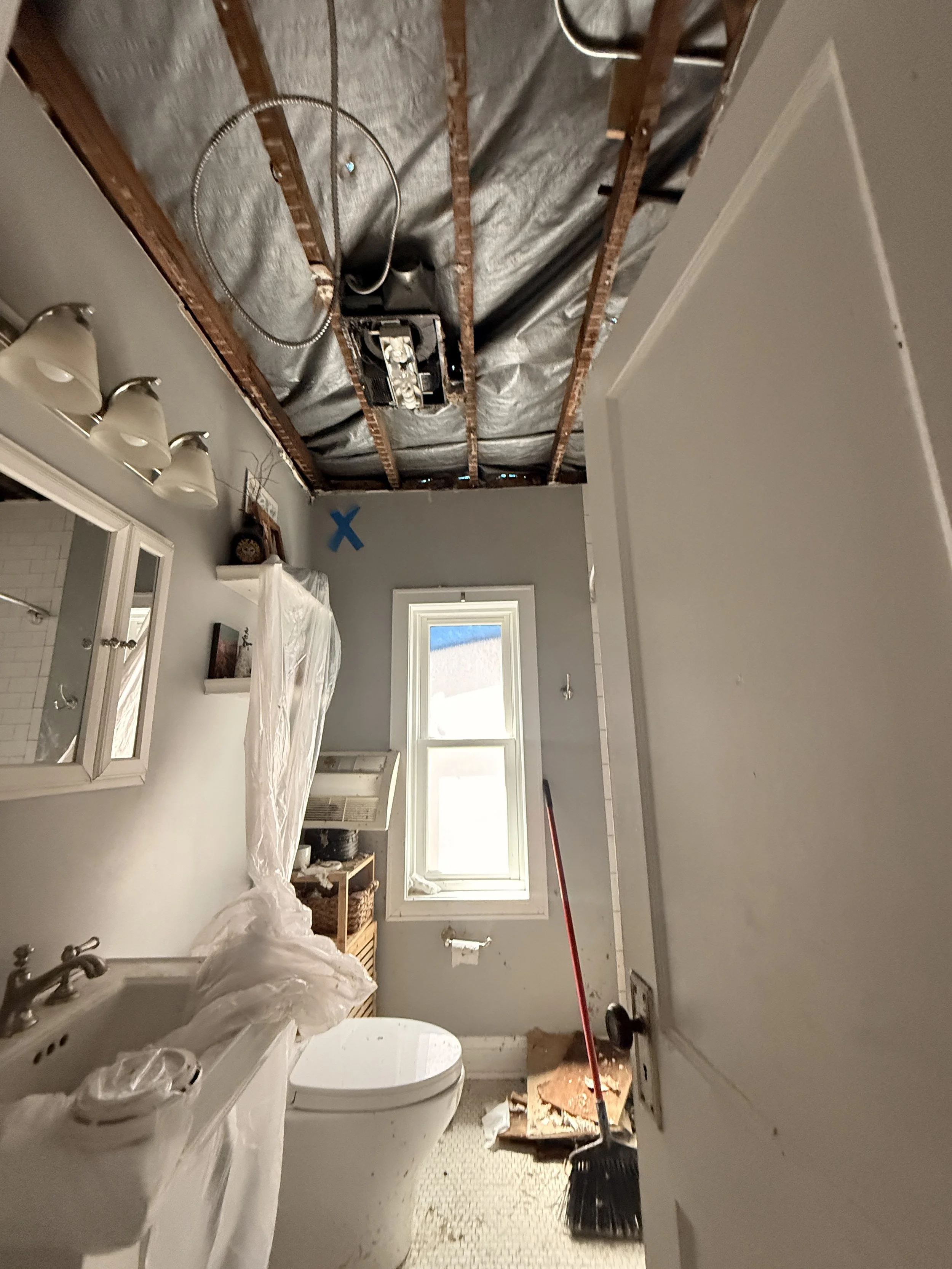

  • Chicago experienced significant, unexpected storms on Monday. The strong window of the storm overcame the tarp covering the front of the house, causing damage to the ceilings at the front of the house.

    • The ceilings in the front room, front bedroom, dining room, and bathroom will need to be replaced with new drywall

    • The hardwood in the front room will either need to be replaced or, hopefully, refinished as originally anticipated.

    • A new bathroom fan on the first floor will need to be installed

    • The basement will require new laminate in the main room due to water penetrating down to the basement and settling under the flooring

    • Drywall will need patched in places where damaged

  • Construction:

    • Ceilings in the front room and bathroom were removed

    • Framing materials for the second floor and roof enclosure were ordered and scheduled for Monday delivery

Week of July 20, 2026

Construction:

  • The framing team determined that the best way to sister the existing 2×4s holding up the ceiling is to use 2×10s. The central portion of the house, above the stairs up to the attic and a portion of the bathroom and dining room, have added 2×10s already in place.

Week of July 13, 2026

  • The kitchen and bedrooms were sealed with plastic sheeting, the floors covered.

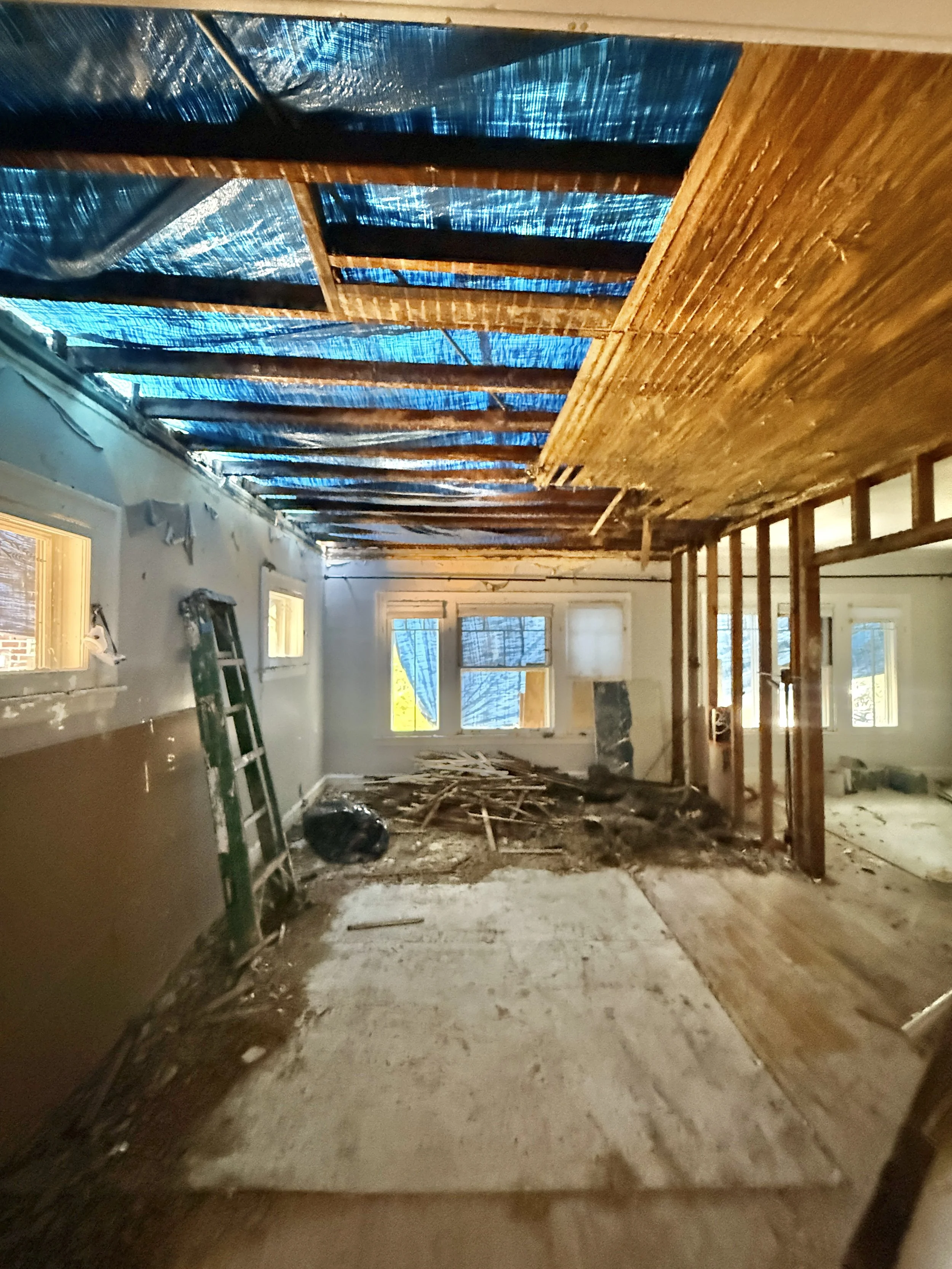

  • The team demo'd the top floor (see photos below) and assessed the best way to frame the joists to support the new top floor.

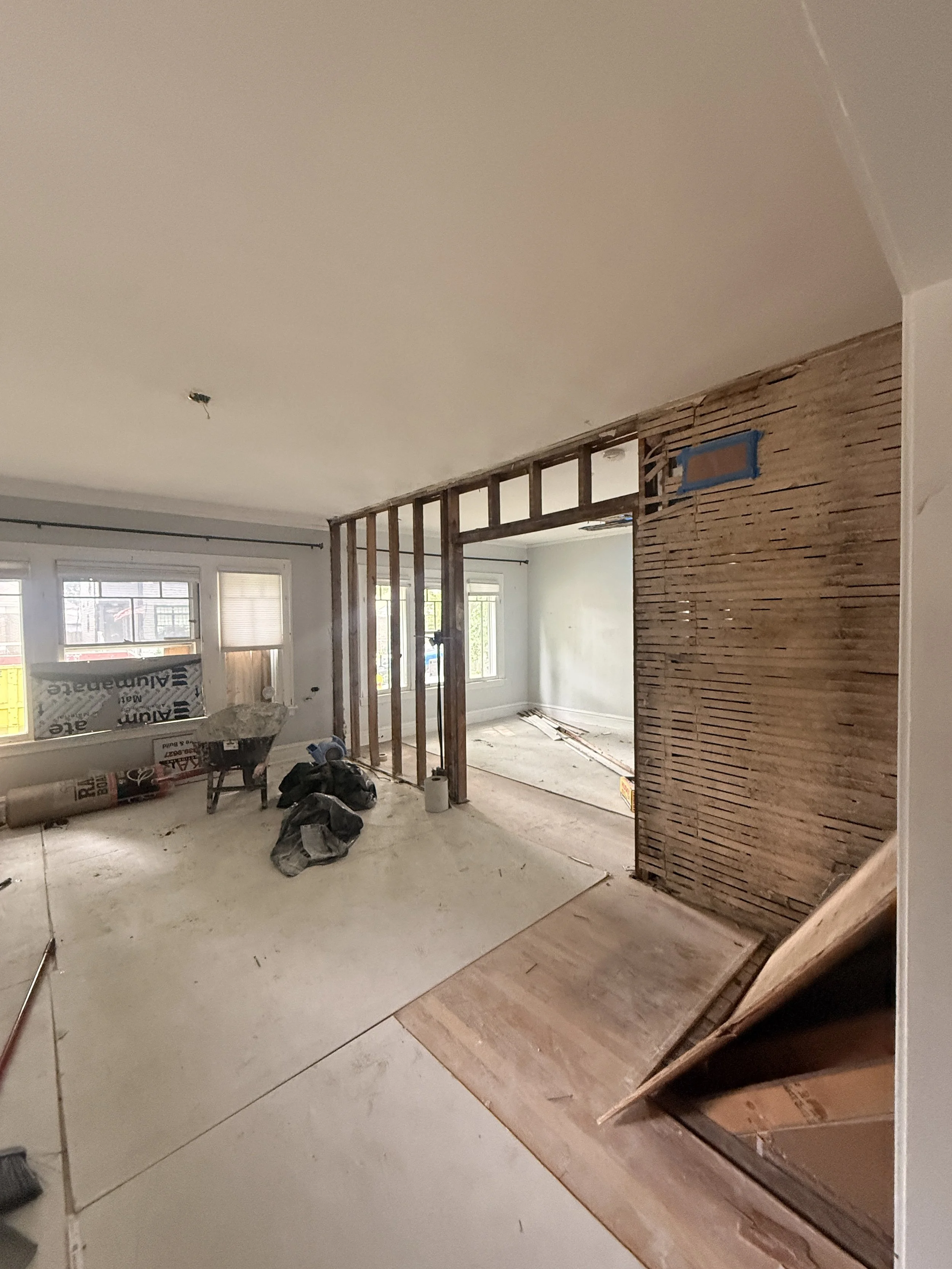

  • The wall between the front rooms was opened up to assess how to move anything running through that wall. It appears to only be electric, which is great news.

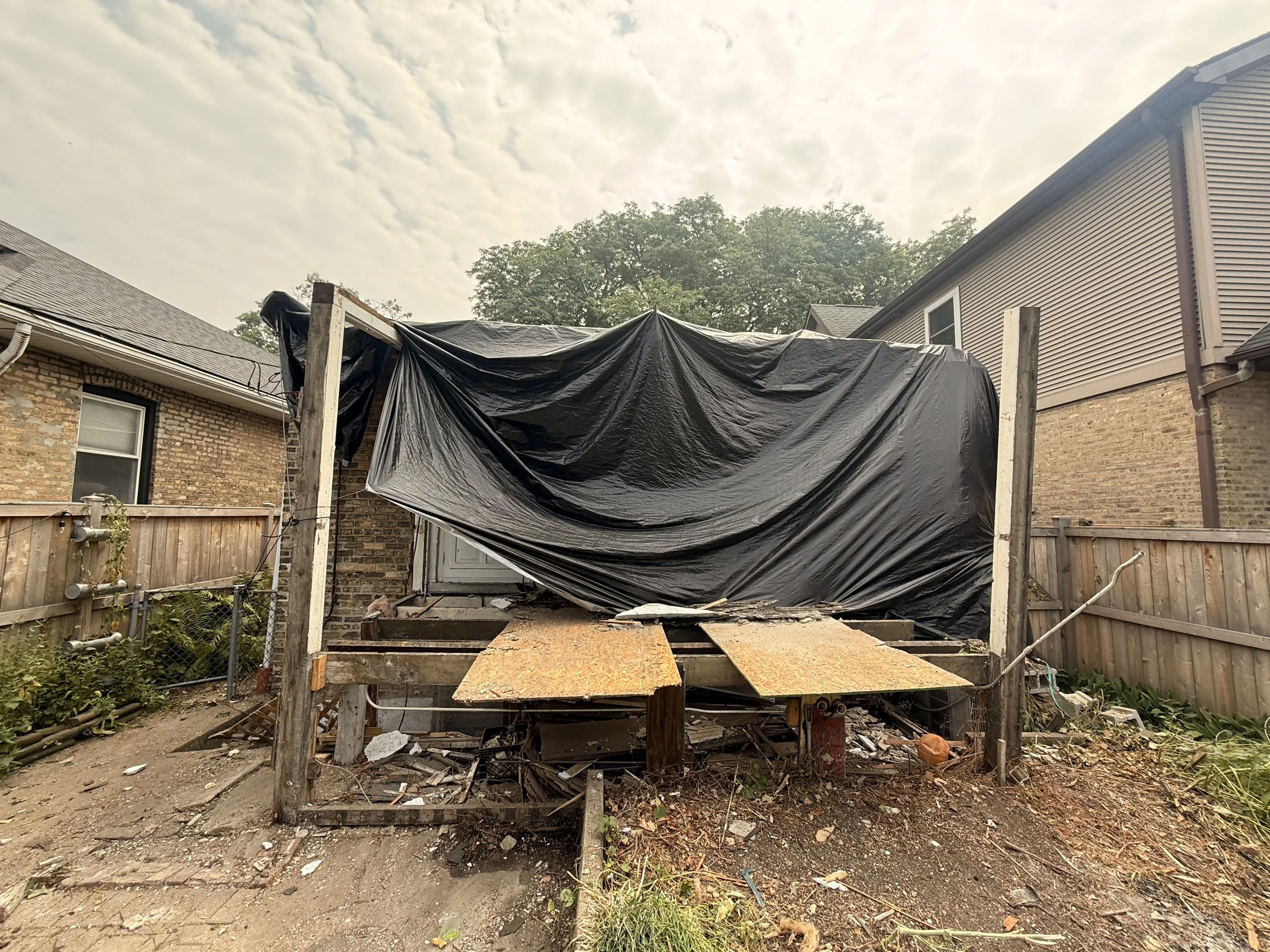

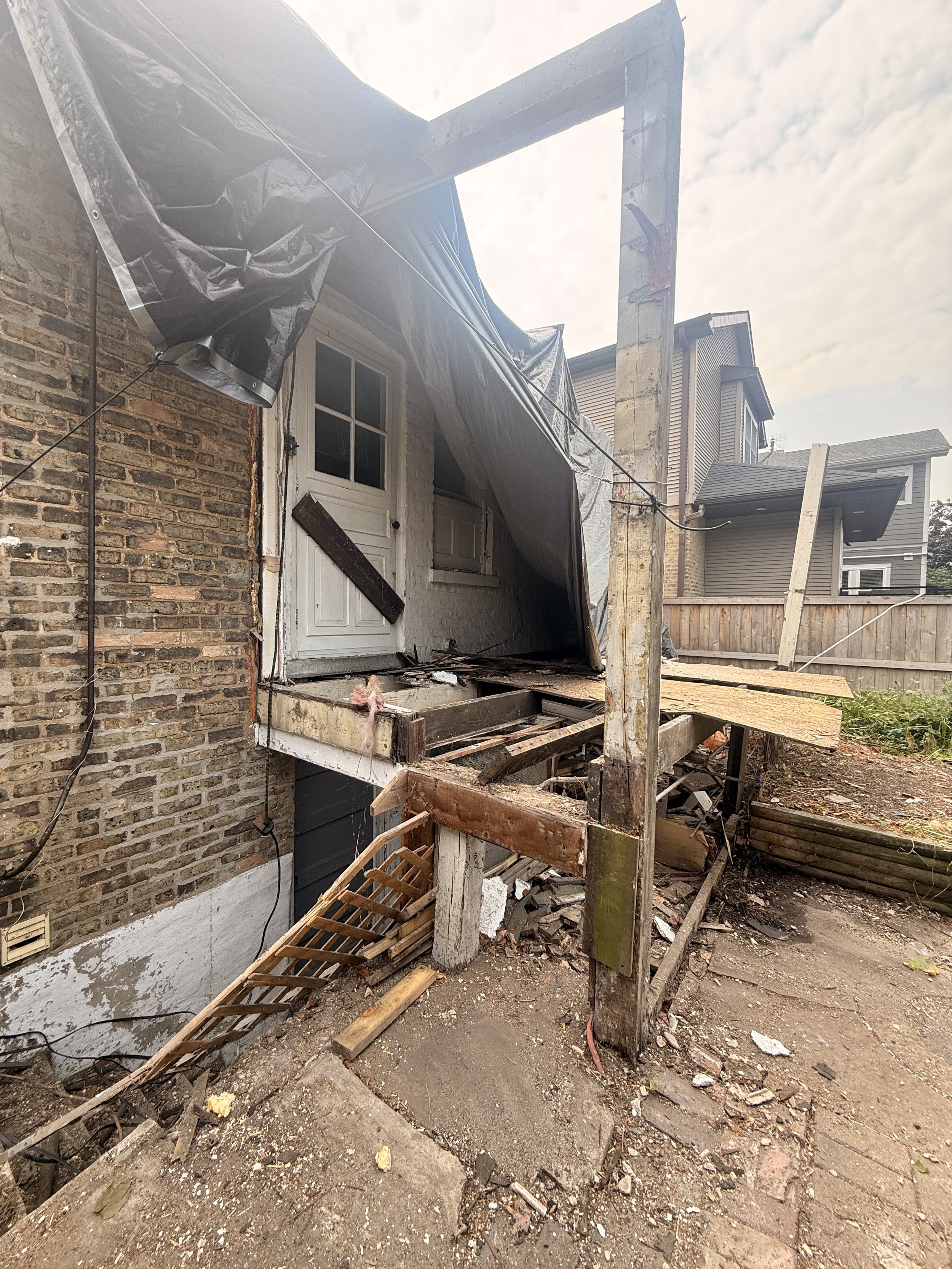

  • The rear porch was opened up and it quickly became clear that the existing framing was not structurally sufficient to preserve and reuse as the bones of the new back porch. It was fully demoed and will need to be reframed. Manuel is currently assessing the additional materials and labor needed to ensure this is done well and in line with the original plans. We are working with him to ensure that this added work is conscious of the timeline and budget.

Week of July 6th, 2026

  • Manuel & team met with Jeff & Aaron on site to go over the plans - a number of questions for the owners were presented and detailed clarified to ensure straightforward project progress.

  • Aaron emailed Matt & Anna questions (email subject: Project Kickoff & Questions) - see thread for full details

  • The following decisions were confirmed:

    • EXTERIOR SIDING: Iron Grey

    • ROOF SHINGLES: Charcoal

    • FRONT GABLE WINDOW: Prairie Style Grids

    • Front closet to be sealed off from the living room side and left alone

    • Stained handrail and straight spindles (in line with the basement stair style

    • FIXTURES: flush mount, chandelier, sconce to be saved, NOT FAN

    • Bathroom Vanity will be 72” (wall is 6’9”) - sconces on either side with single 60×30” mirror

    • Closet door to front room to be sealed, closet left without access

    • Stair wall to be moved 10” to accommodate stair run and avoid soffit

    • Front bedroom door to be moved 36” to the west to allow door to swing into entry space

Client Work:

  • None at the moment

Completed this week:

  • Site preparations, scoping, assembling material needs, requesting bids (windows, doors)
